What’s Your Solution to Internal Corrosion?

Contact us now

The Problem

Pipelines transporting corrosive liquids require an internal lining to prevent corrosion that would shorten the life of the pipeline.

Long distance and high-pressure pipelines generally require welded joints.

The question is: how to protect the interior steel of the weld zone from corrosion when the weld arc would destroy a corrosion-resistant polymer at this location.

The FlexSleeve® Solution

FlexSleeves inserted into pipe ends protect the weld zone from corrosion

pipeline corrosion protection

High Cost & High Risk of Existing Solutions

A common solution for pipelines with internal linings has been to use a robot to paint the joints after welding. The idea may sound good, but in reality months of delays, huge robot-caused cost over-runs, and quality issues due to unpredictable environmental and weld conditions are the norm.

worker-working-on-insert-sleeve

Robots crawl through the pipeline after mainline welding crews. Each joint must be grit blasted, cleaned, painted, and tested for proper cure and continuity. With LPS’ system the internal corrosion protection is complete when the weld is complete.

Using a robot to paint the welds leaves tie-in crews far behind mainline crews, waiting for the robots to finish their work. LPS’ system allows for fast pipeline construction with pipe strings lowered in into the ditch and buried soon after welding.

Effect of Robot On Schedule

LPS received feedback from Contractors and Engineers on four projects that used robots to coat internal joints in Chile: BHP Billiton EWS, BHP Billiton Spence, BHP Billiton Escondida & AMSA El Mauro Tailings Return Water. On all of them the robot was severely behind schedule.

Robot vs. Mainline graph

The productivity of the robot on the right of way and at double jointing yards is slow and unpredictable. The data used in this chart came from Contractor feedback on a project in Chile constructed with double-jointed 24m pipe sections.

Construction Complexity: Tie-Ins

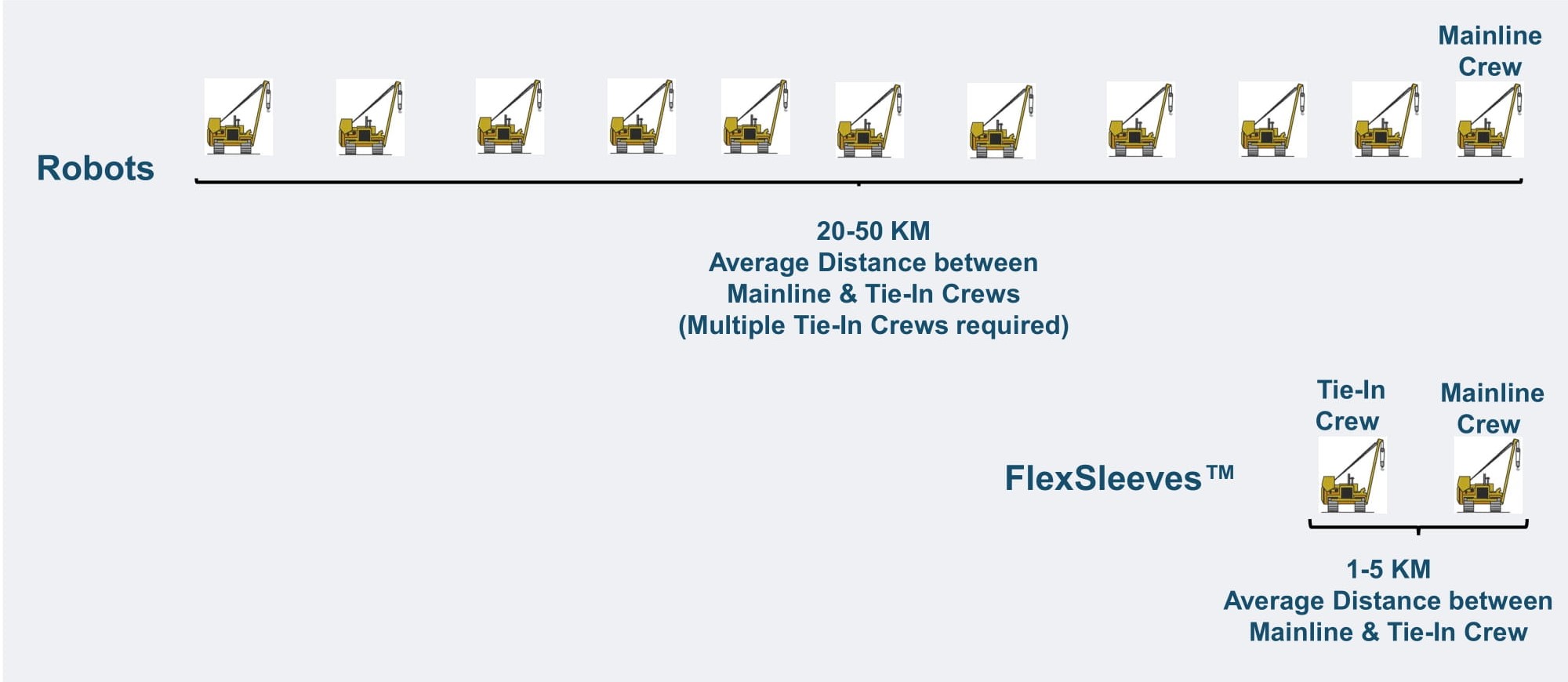

Tie-in crews follow behind the robots, which proceed at a slow, unpredictable rate. A typical project involves the use of several robot crews, each requiring Contractor equipment support with side-booms, transportation, and generators. Tie-in crews are usually far behind mainline crews and support logistics are required to be strung out over vast distances. The complexity of construction is significantly increased, leading to increased cost and delays.

When FlexSleeves are used, the joint is complete as soon as it passes NDE. Tie-in crews are close behind the mainline crew like normal pipeline construction projects.

Coating Quality Problems with Robots

Topic Robot FlexSleeve®
Steel Temperature Epoxy protective materials are generally not applied to steel above 40 C or below 0 C. Cold temperatures significantly lengthen cure time. Hot steel temperatures can cause epoxy to sag or bubble. Protective materials are applied in controlled shop setting, completely eliminating all quality problems associated with field-applied patches.
Humidity Steel temperature must be above dew point when liquid epoxy is applied. Protective materials are applied in controlled shop setting, completely eliminating all quality problems associated with field-applied patches.
Adhesion to Parent Pipe Coating Edge of existing pipe coating must be properly abraded. Fusion bonded epoxy (FBE) is difficult to bond to. Insufficient adhesion and excessive abrasion of parent pipe coating may lead to failures when in service. Bore Seal seals against parent pipe coating and eliminates need to tie into factory-applied pipe lining.
Weld Penetration Special requirements for extra-smooth weld penetration required. High risk of epoxy pinhole leaks on jagged weld surfaces. Lining pinhole formation on welds – AFTER having passed holiday test – are common. Joints can be welded using most standard weld methods. Weld penetration irrelevant with FlexSleeve serving as backing ring.
Pipe lining protective materials Fusion bonded epoxy (AWWA C-213) and polyurethane (AWWA C-222) are widely used to line pipe interiors, yet robot faces massive quality challenges when applying these materials in field. FlexSleeve can be used with any internal pipe coating. Sleeve coating meets or exceeds requirements of parent pipe coating.

Schedule & Cost Comparison

Topic Robot FlexSleeve®
Schedule Robot cannot keep up with mainline weld crews. Each joint is grit blasted, cleaned, painted, and holiday tested after NDE has been performed on the weld. Installation takes less than 1 minute per joint, is done ahead of mainline crew, and can be scaled to keep up with mainline crew or double jointing operation.
Schedule

Contractor tie-in crews, equipment, and other resources remain behind with robots. Project completion must wait for robots & tie-in crews to finish, often increasing project duration by months.

No subsequent steps required after welding. After NDE and external joint coating the pipe can be buried just like normal pipeline construction.

Schedule: Tie-ins

Most long distance pipelines have a tie-in every ~ 1km. Robots require tie-ins every ~500m and must travel long distance to perform all steps on tie-in welds, generally taking an entire shift to complete one tie-in.

Permits normal frequency of tie-ins. FlexSleeve allows for faster tie-ins with joint interior protected as soon as weld is complete.

Schedule: Double-jointing Robot cannot keep up with double jointing operation.

FlexSleeve installation can keep up with double-joint welding rate.

Cost Total cost is far higher when including schedule delays, lengthened mobilization of tie-in crews & equipment, and robot support labor/equipment. Far less total cost.

Welding Considerations

Topic Robot FlexSleeve®
Weld Penetration

Special requirements for extra-smooth weld penetration required. High risk of epoxy pinhole leaks on jagged weld surfaces. Lining pinhole formation on welds – AFTER having passed holiday test – are common.

Joints can be welded using most standard weld methods. Weld penetration irrelevant with FlexSleeves serving as backing ring.

Automatic welding

Many automatic weld methods include an internal weld bead, which is possible with robot lining joints after welding.

Automatic weld methods that weld only from OD must be used. LPS provides specialized internal lineup clamp for use with automatic welding.

NDE of welds

Standard RT & UT methods. Robot must wait until after weld passes NDE in order to coat internal weld joint.

Standard RT & UT methods. NDE technician takes into account the geometry of sleeves under the weld when interpreting results.

Weld repairs Weld repairs: standard weld repair methods.

Standard weld repair methods, with care taken to not grind past ring OD when grinding out weld defects.

Pipe alignment & welding

Mainline welding crew is able to align and weld pipe how they are accustomed to doing so with bare pipe.

Pipe alignment is similar to standard methods. LPS provides beveled “stab guide” that guides free pipe over FlexSleeve end. Standard welding pace & methods.

Projects Highlighting Robot Risk

BHP Billiton Escondida Mine EWS Project, Chile (2014 – 2017) BHP Billiton Spence Growth Project, Chile (2019 – 2020) AMSA Los Pelambres Mine El Mauro Tailings Project, Chile (~2007 – 2009)
2 ea. 42” x 170km desal water lines. EPC: Bechtel.

36” x 154km desal water line. Contractor: Saipem.

32” dia. x 60 km tailings return water line. Design engineer: Ausenco

Robot Cost (17 robots): $29m USD Comparative Cost for LPS Technology: ~$35m USD

Mainline weld crew was at least 40 km ahead of robot.

Robot extremely far behind schedule, with comments from Ausenco’s Chile office stating that it was unlikely they would recommend it again for a project.

Construction pace: 1,400 meters/ day Robot pace: 200 – 800 meters / day

Internal weld penetration had to be manually ground down because it was not sufficiently smooth to achieve a pinhole-free coating. Robots had thixotropic issues with paint material related to steel temperatures, causing the paint to run down the pipe wall.

Bechtel’s total cost incl. schedule delays, support personnel, support equipment & hand-coating some joints: $110m USD
